Nordic data centre construction is the fastest-growing part of the European market. Hyperscale operators build in Sweden, Denmark, Norway and Finland for four reasons. The climate is cool, so cooling costs less. There is plenty of renewable power. Grid capacity is easier to get than in the older hubs. And governments have courted the sector.
How Fast Is Nordic Data Centre Construction Growing?
Research published in July 2026 puts growth in the Nordic data centre construction market at 22.34% a year from 2025 to 2031.
But that sits inside a wider European picture. Arizton values the European market at close to USD 17 billion in 2025, rising to roughly USD 59 billion by 2031.
The effect on the ground is simple. Campuses planned as single buildings five years ago now run in phases. So firms have to prove they can repeat a package, not just deliver one.
What Does the Cooler Climate Actually Save?
Cool air allows free cooling for much of the year. That cuts the energy needed to hold the halls in range. It also improves PUE. Operators name it as a main reason for picking Nordic sites.
The build effect is less obvious, but it is real. A lower cooling load changes the plant footprint. It also changes the weight the structure carries and the size of the plant yards. In turn, more of the cost and risk sits in the shell.
Where Does the Power Come From?
First, renewable power is why the region can absorb this load at all. Norway runs its estate largely on hydro. In Finland, operators buy wind power directly. Sweden and Denmark mix wind, hydro and grid links.
Policy has mattered too. Several governments set tax and grid access terms to draw the sector in. For example, Denmark has published a national AI strategy. Meanwhile, other European markets have grown wary of new data centres. The Nordic position has stayed open.
Why Is Denmark Different?
Denmark’s district heating network gives waste heat somewhere to go. That is unusual at scale. Operators there link the halls into the network, so the heat is reused rather than dumped. Similarly, Norway runs a heat reuse project at Rjukan.
For a contractor, this means extra below-ground services, plant rooms and connection structures. By contrast, a German site would not carry them. It is a planning issue more than a build issue.

What Nordic Data Centre Construction Means on Site
Winter Is Designed In: Heated enclosures, an adjusted mix, a revised curing regime and a labour plan built around short daylight. Typically, programmes finish the groundworks and slab before a winter rather than through one. Where that is not possible, price the method honestly at tender.
Sites Are Remote: Greenfield campuses sit far from major cities. So concrete supply, batching, crew housing and plant movement all change. Batch distance in particular limits what one pour can achieve.
Repeat Delivery Is the Test: Multi-phase campuses want the same crew, the same method and the same result each time. So developers pick on delivery record, not lowest price. A failure on phase two costs more than the saving on phase one.
Cross-Border Labour Is Normal: Working across Sweden, Denmark and Germany means posted worker rules, different safety regimes and language cover on site. It adds paperwork. Because of that, few subcontractors hold real multi-country hyperscale experience.
Our own record covers 435,000 m² of slabs, 200,000 m³ of concrete and 22,500 tonnes of rebar. That sits across eleven completed hyperscale packages in Sweden, with five more live.
Frequently Asked Questions
Why do hyperscalers build data centres in the Nordics? Cool climate, plentiful renewable power, available grid capacity and supportive government policy.
How fast is Nordic data centre construction growing? Forecasts put growth at 22.34% a year from 2025 to 2031.
Which Nordic country attracts the most investment? Denmark, Sweden and Norway have all drawn large hyperscale investment. Denmark’s district heating and Norway’s hydro power stand out most.
Does the cold climate make construction harder? It adds a real constraint on external works and concreting. Still, it is manageable with heated enclosures, a mix change and revised curing. Plan it from the start.

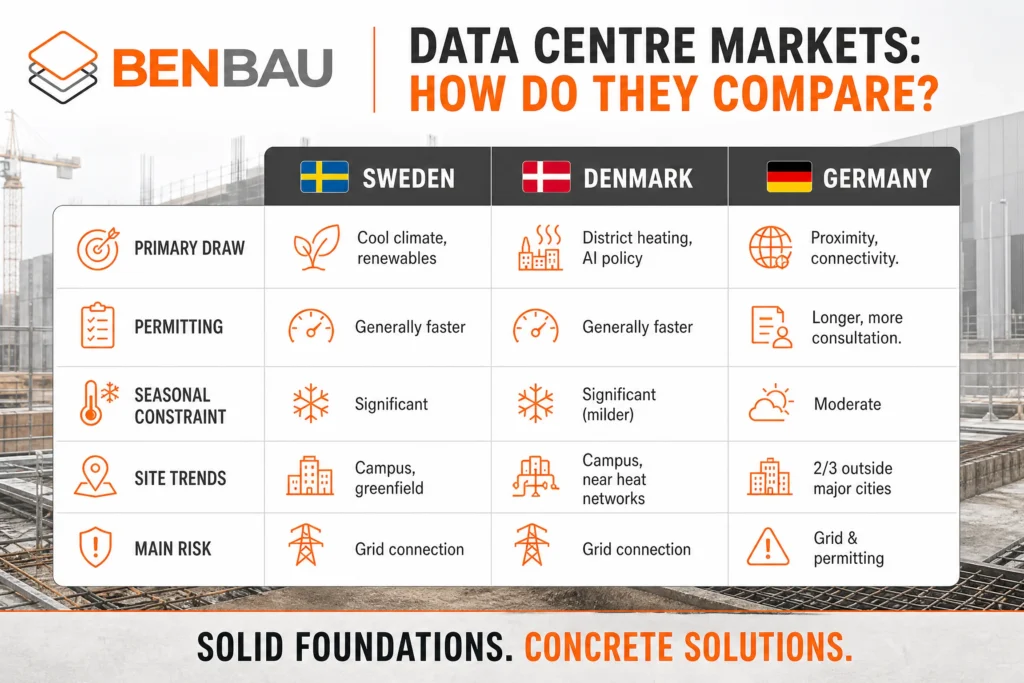

How does Nordic data centre construction compare with Germany? The Nordics offer faster consent and better renewable supply. However, the seasonal constraint is stronger. Germany offers closer demand centres and better links, but longer permits. See our guide to the data centre construction timeline.
