A hyperscale data centre construction timeline in Europe now runs 18 to 24 months on site. A few years ago it was closer to 12. Grid connection and long-lead electrical equipment cause most of the added delay. Groundworks and concrete take the first four to eight months of the programme.
What Is a Typical Data Centre Construction Timeline?
Published figures put the average hyperscale build at 18 to 24 months. That covers the construction period alone.
However, it does not cover land assembly, grid application, planning consent or design. On a European site those can add one to four years. The gap matters. When a developer says a site is three years away, they usually mean three years to power. The build is the shorter and more predictable half.

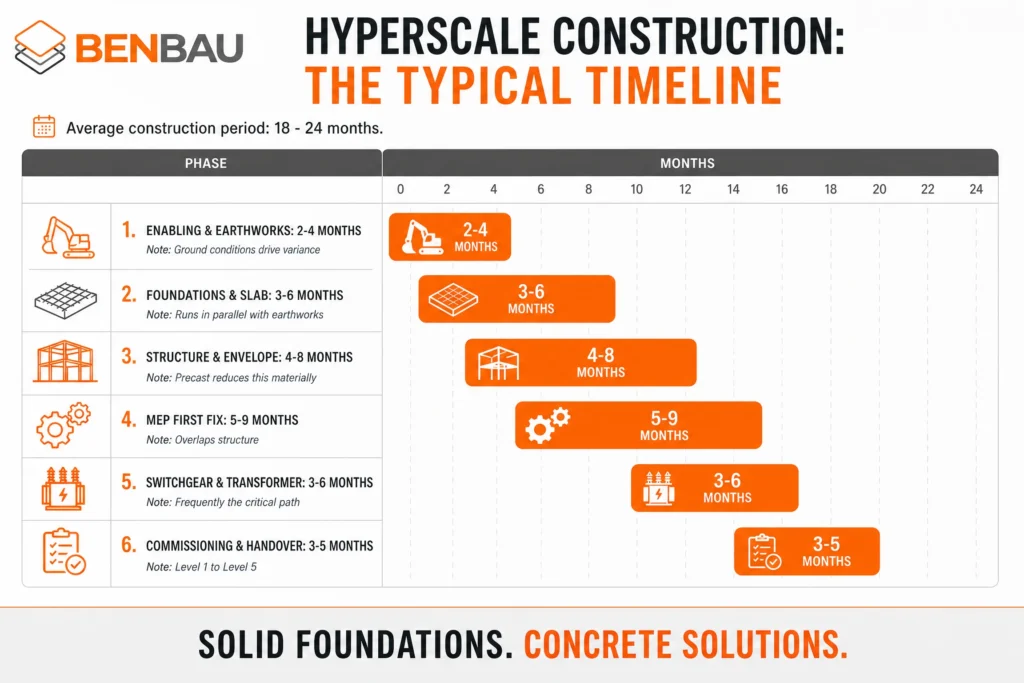

The table below sets out rough phase durations for a single hyperscale building. Treat them as planning ranges. In practice the phases overlap heavily.

Why Has the Data Centre Construction Timeline Grown Longer?
Grid Connection: Across Europe, the grid decides what can open. CBRE’s European Data Centres Outlook 2026 forecasts vacancy in the main markets falling to a record low of 6.5% by the end of 2026. Demand runs well ahead of what the network can energise.
Long-Lead Equipment: Switchgear and transformers now sit on the critical path of most schemes. A slab poured on time delivers nothing if the kit that lands on it is nine months late.
Labour: Contractor backlogs on data centre work are long. The tightest trades are electrical rather than structural. Concrete crews are easier to find than commissioning engineers.
Where Does Concrete Sit in the Programme?
Early. It also sits on the critical path for everything after it.
Foundations, ground slabs, plinths, generator bases and containment all have to cure before structure and mechanical installation start properly. A concrete package that finishes two weeks late does not cost two weeks. It squeezes every trade behind it into a shorter window. That is usually where change orders and quality problems begin.
As a result, developers award concrete scope earlier than they would on a commercial building. They also weight delivery record above price. Our own work to date covers 435,000 m² of slabs, 200,000 m³ of concrete and 22,500 tonnes of reinforcement. That sits across eleven completed hyperscale packages in Sweden, with five more live.
What Pushes a Data Centre Construction Timeline Off Track?
Late Design Freeze: Analysis reported by Archdesk in 2026 found change orders at 3% to 5% of contract value where design was locked at around 60% completion. Where design ran on in parallel with the build, the figure was 8% to 14%. In other words, most of that gap is avoidable.
Ground Conditions Found Late: Peat, high water tables and variable bearing capacity are common on the greenfield sites now in use across Germany and the Nordics. A thin ground investigation often costs two months on site.
Winter Without a Plan: Concrete still goes in through a Nordic winter. It needs heated enclosures, an adjusted mix, a revised curing regime and a labour plan built around short daylight. Typically, programmes written in summer miss this.
Split Sequencing: Where the slab, the underground services and the containment works sit with different subcontractors, and nobody holds sequencing authority, the interfaces slip.
How Do Germany, Sweden and Denmark Compare?
Germany carries the heavier permitting and consultation load. Around two-thirds of German projects now sit outside the major cities. Site access and local labour supply therefore enter the programme in a way they did not on Frankfurt sites.
Sweden and Denmark move faster through consent. In return they impose a real seasonal limit on external works. Developers active in both markets understand the trade-off well. For example, it explains why Nordic campuses are often planned to finish the substructure ahead of a winter rather than through one.
Frequently Asked Questions
How long is a data centre construction timeline in Europe? Around 18 to 24 months on site. Land assembly, consent, grid application and design add one to four years before that.
What is the longest lead item on a data centre project? Grid connection, then switchgear and transformers. Both usually run longer than the building work.
How long does the concrete package take? Four to eight months for foundations and slabs on a single building. Ground conditions, campus layout and parallel working all shift it.
Can concrete be poured through a Nordic winter? Yes. It needs heated enclosures, an adjusted mix and a revised curing regime, planned from the start.
Does design-build shorten a data centre construction timeline? It cuts change orders where design is locked before the build starts. Where design runs on in parallel, the contract route makes little difference.
